Access to nature
Long-term solutions
The Norfolk Coast Path National Trail team is working to improve accessibility and enhance the visitor experience at Beeston Bump and Skelding Hill, near Sheringham. These popular sections of the trail experience around 200,000 visits each year, and improvements are being delivered to create a more durable, accessible and sustainable route while protecting the surrounding landscape.
What we’ve done so far
In January, we held a community drop-in event in Sheringham, with more than 50 local residents and visitors attending to learn about the project and share their views. The feedback received helped shape the development of the proposals and informed the final design solutions for both locations.

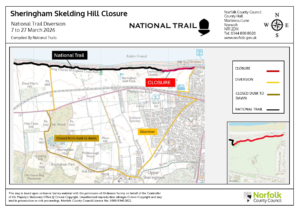

We also carried out temporary repair works at Skelding Hill to improve access while longer-term solutions were developed. Following further site investigations and technical assessments, we commissioned a detailed design for the project and worked with specialist consultants to develop sustainable improvements that balance accessibility, public enjoyment and environmental protection.
The completed designs include:
- A wider path surface, increasing the route width by up to 1.5 metres in key locations.
- Improved drainage and upgraded surfacing to create a more resilient and longer-lasting path.
- New steps and retaining structures at Beeston Bump.
- Handrails on steeper sections of Skelding Hill to provide additional support.
- New passing places and seating areas to allow visitors to rest and enjoy the views.
Current progress
Construction works began in October 2026 following the completion of design and logistics planning. Since then, contractors have undertaken earthworks, drainage improvements, soft landscaping and path construction, with significant progress made at both Beeston Bump and Skelding Hill.
Project timeline
- October 2026: Logistics finalised and construction works commenced.
- November 2026: Beeston Bump works reach approximately 50% completion.
- December 2026: Beeston Bump works nearing completion.
- January 2027: Beeston Bump scheduled to reopen, with Skelding Hill works reaching approximately 50% completion.
- February 2027: Skelding Hill works nearing completion.
- March 2027: Target date for completion of the overall project.
Looking ahead
Once complete, the improvements will provide a more accessible and resilient route for the many people who enjoy this stretch of the Norfolk Coast Path National Trail, while helping to protect the surrounding coastal landscape for future generations. We will continue to share progress updates on this page as the project moves forward.
